Introduction
Many property owners in Dubai assume that demolition ends when the walls come down.
It does not.
The foundation is what sits below ground — and in Dubai, Dubai Municipality requires full foundation removal before a completion certificate is issued and a new construction permit can begin.
Foundation demolition is one of the most technically demanding parts of any demolition project. It requires heavy equipment, proper planning, and a clear understanding of what lies underground.
This guide covers everything you need to know about foundation demolition and deep excavation in Dubai — including real site challenges, equipment, authority requirements, and a real project case study from Al Zelzal Demolition Works LLC.
What Is Foundation Demolition?
Foundation demolition means removing all below-ground structural elements of a building after the superstructure (walls, columns, slabs, roof) has been demolished.
This includes:
- Reinforced concrete footings
- Ground beams
- Pile caps
- Raft slabs
- Strip foundations
- Basement walls and slabs (if applicable)
⚠️ Important: In Dubai, leaving foundations in the ground after demolition is not permitted. Dubai Municipality inspection will fail the site if foundations are not fully removed.
👉 Related: Demolition Completion Certificate in Dubai Municipality (2026)
Why Foundation Demolition Is Harder Than Superstructure Demolition
Superstructure demolition — walls, beams, slabs above ground — is visible and relatively straightforward.
Foundation demolition is different because:
- Foundations are buried underground (typically 1.5m – 4m+ depth in Dubai)
- Reinforcement is heavy and densely packed
- Concrete is often high-strength mix
- Underground services may be nearby
- Groundwater or sandy soil can complicate excavation
- Access for machinery is limited once excavation begins
This is why foundation demolition takes longer, costs more, and requires more careful planning than the above-ground structure.
Types of Foundations Found in Dubai Properties
Understanding the foundation type before starting demolition is essential for selecting the right method and equipment.
1. Isolated Footings (Most Common in Villas)
Individual concrete pads under each column.
- Depth: typically 1.0m – 2.0m
- Straightforward to remove with excavator and breaker
- Most common in ground floor and G+1 residential villas
2. Strip Foundations
Continuous concrete strip under load-bearing walls.
- Common in older Dubai properties
- Depth: 0.8m – 1.5m
- Removed in sections using hydraulic breaker
3. Raft Foundations
A solid reinforced concrete slab covering the full plot area below ground.
- Common in larger buildings and areas with weak soil
- Depth: 0.5m – 1.5m thick slab
- Requires heavy breaking and significant excavation volume
4. Pile Foundations
Deep concrete or steel piles driven into the ground.
- Common in high-rise and heavy commercial structures
- Depth: can reach 10m – 20m+ in Dubai
- Requires specialist pile removal equipment
- Most time-consuming and expensive foundation type
5. Ground Beams
Reinforced beams connecting footings or piles below ground level.
- Must be removed along with footings
- Often hidden and discovered only during excavation
Equipment Used for Foundation Demolition in Dubai
Equipment Purpose Hydraulic excavator (20–35 ton)Main excavation and material handling Hydraulic breaker attachment Breaking hard reinforced concrete Crusher / pulverize attachment Crushing concrete for recycling Bobcat / skid steer Confined space clearing Dump trucks Debris and soil transport Water tanker Dust suppression
The excavator with hydraulic breaker is the core machine for foundation demolition.
For deep pile removal, specialist rigs may be required — this is a separate scope from standard foundation breaking.
Step-by-Step Foundation Demolition Process in Dubai
Step 1: Superstructure Demolition First
Foundation demolition always starts after the full superstructure is removed.
The site must be clear of all above-ground structure before excavation begins.
👉 Related: Manual vs Mechanical Demolition in Dubai (2026 Guide)
Step 2: Mark Underground Services
Before any excavation:
- DEWA cable and water pipe locations must be confirmed
- Etisalat and Du telecom lines must be cleared
- Trial pits are dug manually to expose and verify service locations
⚠️ Mechanical excavation near live underground services without verification is a serious safety violation in Dubai.
👉 Related: DEWA Disconnection for Demolition in Dubai (2026 Guide)

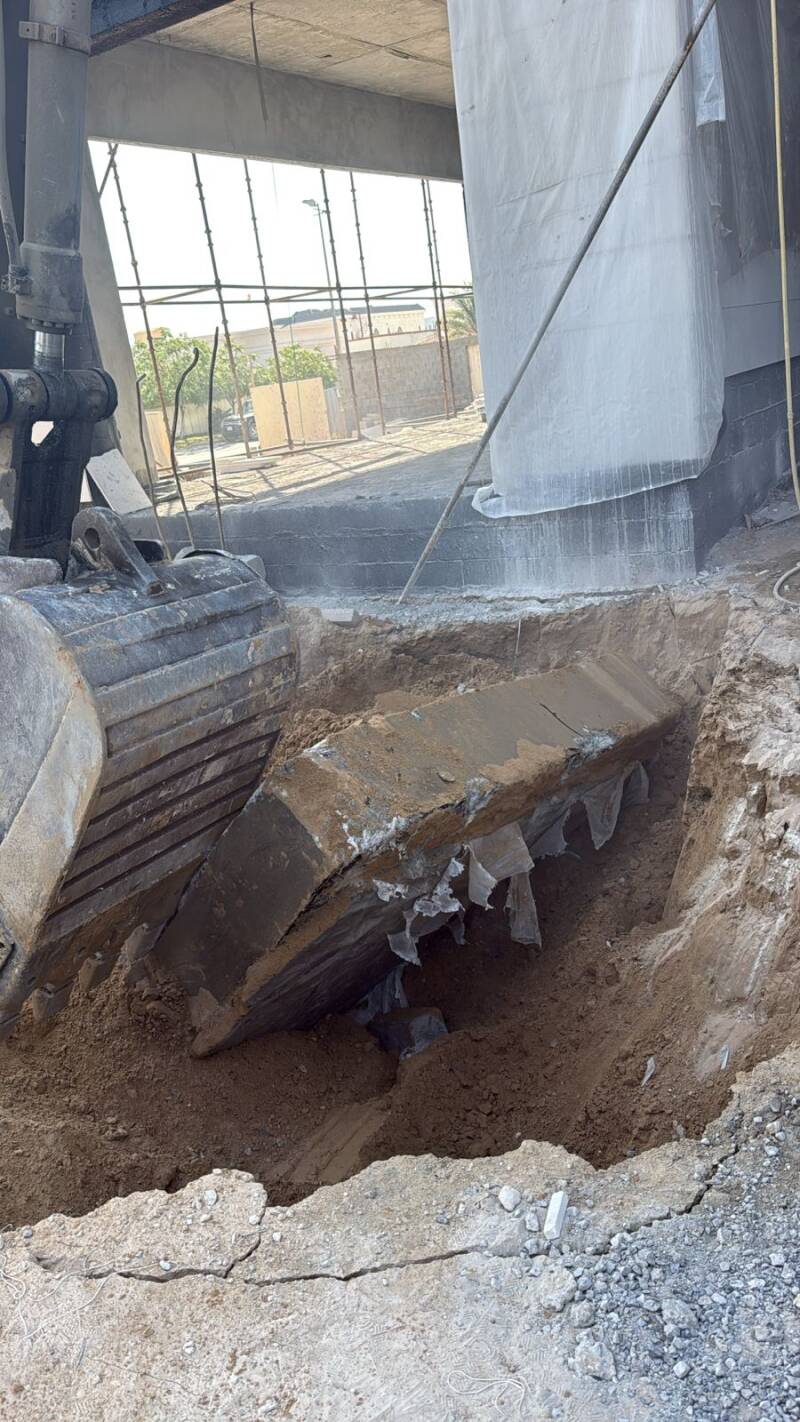

Step 3: Excavation Around Foundations
The excavator opens the ground around the foundation elements to expose them fully.
This typically means excavating:
- 0.5m – 1.0m around isolated footings
- Full depth of strip or raft foundations
- Deep trenches for pile caps and ground beams
Excavated soil is loaded into dump trucks and removed from site.
Step 4: Breaking Reinforced Concrete
Once foundations are exposed, the hydraulic breaker attachment is fitted to the excavator.
Breaking sequence:
- Break concrete cover from rebar
- Break concrete in sections
- Cut or pull out reinforcement steel
- Load broken concrete into dump trucks
Reinforcement steel (rebar) recovered during this process has scrap value.
👉 Related: Recovering Value: How Salvage & Recycling Can Reduce Demolition Costs in Dubai (2026 Guide)
Step 5: Removal of All Foundation Elements
Every footing, ground beam, pile cap, and slab must be fully removed.
Nothing can be left in the ground.
Dubai Municipality inspection will check:
- Depth of clearance
- No concrete remains below ground level
- Site is ready for new construction
Step 6: Backfilling (If Required)
After foundation removal, the excavated area must be properly addressed.
Options depend on project requirements:
- Backfill with clean selected fill (compacted layers)
- Leave open for new construction to begin
- Level the site to natural ground level
Backfilling must use approved materials. Debris or demolition waste cannot be used as fill.
Step 7: Site Leveling and Final Clearance
Before applying for the completion certificate:
- Site must be fully level
- All debris removed
- No machinery or equipment left on site
- No concrete rubble or rebar visible
👉 Related: Demolition Completion Certificate in Dubai Municipality (2026)
Is Foundation Demolition Included in the Demolition Permit?
Yes — but it must be clearly stated in the Method Statement submitted for permit approval.
The Method Statement must include:
- Foundation type (isolated footings, raft, piles, etc.)
- Excavation depth
- Equipment to be used
- Soil disposal plan
- Underground service protection measures
If foundation demolition is not mentioned in the Method Statement, additional approvals or resubmission may be required.
👉 Related: Demolition Permit Process in Dubai – Step-by-Step Guide (2026 Update)
Foundation Demolition Near Neighboring Boundaries
This is one of the most sensitive situations in Dubai demolition work.
When the foundation is close to a neighboring plot boundary or shared wall:
- Mechanical excavation must stop at a safe distance
- Manual breaking is used near the boundary zone
- No vibration or impact that could affect neighboring structure
- Supporting the neighboring soil may be required before excavation
⚠️ Causing damage to a neighboring property during demolition is a serious legal and financial liability in Dubai.
Experienced contractors plan boundary-adjacent foundation removal carefully and include specific precautions in the Method Statement and Risk Assessment.
Foundation Demolition and Groundwater in Dubai
In some Dubai areas — particularly near the coast, in reclaimed land zones, or low-lying plots — groundwater is encountered during deep excavation.
When groundwater is present:
- Dewatering pumps are required before and during excavation
- Excavation depth is limited until water is controlled
- Soil stability must be assessed before deep breaking
- Foundation removal timeline increases significantly
Areas where groundwater is commonly encountered:
- Deira waterfront
- Port Saeed
- Al Hamriya
- Some areas of Business Bay
- Coastal Jumeirah plots
This must be assessed during the pre-demolition site inspection — not discovered during execution.
How Foundation Demolition Affects Cost
Foundation demolition is priced separately from superstructure demolition in most professional quotes.
Factors that affect cost:
FactorCost ImpactFoundation type (isolated vs raft vs pile)Piles are most expensiveDepth of excavationDeeper = higher costSoil type (sand vs hard rock)Rock increases breaking time significantlyGroundwater presenceDewatering adds costProximity to boundariesManual work near boundaries increases labor costRebar recoveryRecovered steel reduces net costDebris transport distanceAffects disposal cost
In many villa demolition projects in Dubai, foundation demolition costs between AED 5,000 – AED 20,000 depending on size and conditions — on top of the superstructure demolition cost.
Real Case Study: Foundation Demolition – Wadi Al Safa 7, Dubai
Project Location
Wadi Al Safa 7, Dubai
Project Scope
- Full villa demolition (G+1 structure)
- Full foundation removal including isolated footings and ground beams
- Deep excavation up to 2.2m below ground level
- Complete site clearance and leveling
- Completion certificate obtained
Site Challenges Encountered
Challenge 1: Hard Concrete Foundations
The villa had older reinforced concrete foundations with very high concrete density. Standard breaking was slow.
Solution: We switched to a heavier breaker attachment (heavy-duty rock breaker class) which significantly improved breaking speed without damaging the surrounding soil profile.
Challenge 2: Ground Beam Network
After removing the isolated footings, a network of reinforced ground beams was discovered connecting all the footings — not shown in original drawings.
This added approximately 1.5 days of additional breaking and excavation work.
Solution: Full ground beam removal was completed before applying for completion inspection. Site was fully cleared.
Challenge 3: DEWA Water Line Near the Plot Boundary
During trial pit verification, a DEWA water supply line was found running parallel to the eastern boundary of the plot — approximately 0.8m from the edge of the deepest footing.
Solution:
- Manual excavation only within 1.5m of the water line
- DEWA inspection team was notified
- Footing near the line was broken using manual jackhammer only — no mechanical breaker within 1.0m of the pipe
- Written confirmation from DEWA site inspector obtained before final clearance
Project Result:
✔ Full foundation removed to required depth ✔ No service damage during excavation ✔ Site leveled and cleared ✔ Dubai Municipality inspection passed first attempt ✔ Completion certificate issued
Common Mistakes in Foundation Demolition in Dubai
Mistake 1: Not including foundation scope in the Method Statement
If the permit Method Statement only covers superstructure demolition, the contractor may be required to resubmit before foundation work can legally begin.
Mistake 2: Skipping trial pits
Excavating mechanically without first hand-digging trial pits to verify service locations is a major safety risk — and a violation of Dubai Municipality site safety rules.
Mistake 3: Leaving ground beams in place
Ground beams are sometimes missed during foundation removal, especially when they run between footings at depth. Municipality inspection will fail the site if beams remain.
Mistake 4: Using demolition debris as backfill
Crushed concrete rubble cannot be used as clean fill. Approved selected fill must be used. Using demolition waste as fill can cause site rejection.
Mistake 5: Not leveling the site properly
Even after full foundation removal, an uneven site with loose soil mounds will fail the completion inspection.
Authority Requirements for Foundation Demolition
Foundation demolition is covered under the same permit as the overall demolition project. However, specific requirements apply:
- Dubai Municipality requires complete foundation removal for full demolition projects
- DEWA must have disconnected all services before excavation begins
- RTA drainage lines near the plot must be protected
- Etisalat / Du telecom infrastructure must be avoided during excavation
👉 Related: Etisalat & Du NOC for Demolition Dubai (2026 Guide) 👉 Related: DDA Demolition Permit in Dubai (2026)
Foundation Demolition Safety Rules
Key safety requirements during foundation demolition:
- Workers in excavated trenches must have adequate shoring if depth exceeds 1.2m
- No workers allowed in the swing radius of operating excavator
- Continuous dust suppression during breaking and loading
- Hard hat, safety boots, and high-visibility vest are mandatory
- Emergency contacts displayed at site entrance
- No open excavation left unguarded overnight — barriers and warning lights required
👉 Related: Dubai Municipality Circular 2026 for Demolition Contractors – Safety Rules Across Dubai
How Al Zelzal Handles Foundation Demolition Projects
Al Zelzal Demolition Works LLC is a DM-approved demolition contractor in Dubai with over 15 years of experience including complex foundation removal across Dubai.
Our foundation demolition process:
- Pre-demolition site inspection — assess foundation type, depth, access, services
- Method Statement includes full foundation scope
- Trial pits before any mechanical excavation
- Correct equipment selected based on concrete strength and depth
- Careful boundary and service management throughout
- Full site clearance and leveling before applying for completion inspection
- Completion certificate coordination with Dubai Municipality
📞 Call / WhatsApp: 056 780 0464 🌐 www.zelzaldemolition.com 📍 Find us on Google Maps
FAQs – Foundation Demolition in Dubai
1. Is foundation removal mandatory in Dubai after demolition?
Yes. Dubai Municipality requires complete removal of all below-ground foundation elements before the completion certificate is issued. Leaving foundations in place will result in inspection failure.
2. How deep do foundations go in Dubai villas?
Most residential villa foundations in Dubai range from 1.0m to 2.5m depth. Older properties may have shallower foundations. Raft foundations and pile caps in commercial structures can be significantly deeper.
3. Can foundation demolition damage neighboring properties?
If not properly managed, yes. Vibration from hydraulic breakers, unsupported excavation near boundaries, and groundwater changes can all affect neighboring structures. Experienced contractors plan specifically for this and use manual methods near boundaries.
4. How long does foundation demolition take?
For a standard ground floor villa — isolated footings: 1–3 days. Raft foundation: 3–5 days. Ground beams and raft combined: 4–7 days. Timelines increase with depth, soil hardness, groundwater, or site access restrictions.
5. What happens to the concrete removed from foundations?
Reinforcement steel (rebar) is separated and sold as scrap — reducing the overall demolition cost. Concrete rubble is transported to approved disposal or crushing facilities. It cannot be left on site or used as backfill.
6. Is pile removal included in standard foundation demolition?
Pile removal is typically a separate, specialist scope. Standard demolition contractors handle isolated footings, raft slabs, and ground beams. Deep pile removal requires specialist pile extraction rigs and is quoted separately based on pile depth, diameter, and material.
7. What if underground services are found during foundation excavation?
Work stops immediately near the service. The relevant authority (DEWA, RTA, Etisalat, Du) is contacted. Manual work only is used in the proximity zone. No mechanical breaking within the safe exclusion distance from any live service.
Final Conclusion
Foundation demolition is the final — and most technically demanding — stage of any full demolition project in Dubai.
Done correctly, it allows:
- Dubai Municipality completion certificate to be issued
- New construction permit to proceed without delay
- Clean, safe, properly leveled site handover
Done incorrectly, it causes:
- Inspection failures
- Authority disputes
- Neighbor damage claims
- Project delays and additional cost
The key is to plan foundation demolition from the start — not treat it as an afterthought once the superstructure comes down.
Al Zelzal Demolition Works LLC DM Approved Demolition Contractor — Dubai
📞 056 780 0464 🌐 www.zelzaldemolition.com 📍 Find us on Google Maps
Add comment
Comments
