DEWA Disconnection for Demolition in Dubai (2026 Guide): Process, NOC, Timeline & Real Site Issues

DEWA Disconnection for Demolition in Dubai (2026 Guide)

Before starting any demolition project in Dubai, completing DEWA disconnection is mandatory.

It is one of the key NOC requirements before submitting a demolition permit to Dubai Municipality.

Without this approval, demolition applications cannot proceed.


When Should You Apply for DEWA Disconnection?

👉 You must apply before Dubai Municipality demolition permit submission.
Read our previous blog – Demolition Permit Process (Step-by-Step)

Correct sequence:

  1. Confirm demolition scope (full or partial)
    Read our previous blog – Full vs Partial Demolition Rules
  2. Prepare required documents

  3.

    Apply for DEWA disconnection

  4.

    Receive DEWA clearance (NOC)

  5.

    Submit demolition permit


Mandatory Documents for DEWA Disconnection

  • Owner Emirates ID

  • Affection plan (plot plan)

  • Disconnection request letter from owner

  • demolition drawings with 4 coordinates ( partial demolition ).

Important conditions:

  • Owner name must match DEWA records

  • If multiple owners → Power of Attorney is mandatory

  • Any mismatch → application rejection


Application Process

Apply through the official DEWA portal:
https://crm.dewa.gov.ae/irj/portal/anonymous

Must select:

  • Select Full demolition OR Partial demolition

    ⚠️ Notes:

    • Fill all mandatory fields correctly in the application
    • Attach:
      • Disconnection request letter
      • Owner Emirates ID
      • Affection plan (plot plan)
    • No extra authorization letter is required
    • Wrong selection or incorrect details = application rejection

    For Partial Demolition:

    • Demolition drawings are mandatory with 4 side coordinates
    • Drawings must clearly show the proposed demolition area and boundaries

Timeline

👉 7 to 15 working days (typical)

May vary due to:

  • inspection results

  • outstanding payments

  • utility conflicts


DEWA Inspection Process

  • DEWA inspection team visits site

  • Contractor must be present

  • Site must be fully vacant

⚠️ If not vacant → rejection


Payment & Meter Recovery

  • Outstanding bills must be cleared

  • Recovery charges may apply

  • Meters removed after payment


Partial Demolition Rules (Important)

  • DEWA does NOT disconnect or recover meters

  • Contractor handles internal disconnection

  • Must be clearly mentioned in application

Required for partial demolition:

  • 4-side coordinates drawing

If area contains:

  • meter

  • DB

  • water connection

👉 Application will be rejected


Meter Shifting (Separate Process)

  • Required if meter is inside demolition area

  • Only DEWA-approved contractor can apply

  • Demolition contractor cannot process this


Cable / Water Line Passing Through Plot

Step 1: Work Intimation

Submit to:

  • transmission team

  • distribution team

  • LV cable team

Step 2: Site Inspection

  • GPS verification by DEWA

  • Site visit

Step 3: Trial Pit (mandatory)

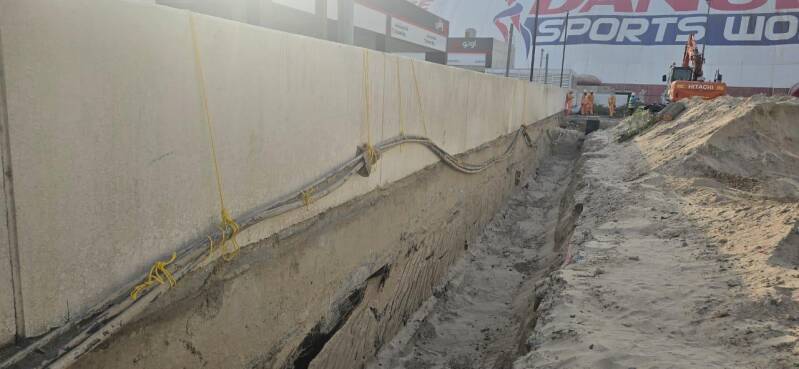

  • Expose cable physically

  • Confirm actual location

Step 4: Drawing Update

  • Show exact cable position

  • Show distance from demolition area

Step 5: Final decision

If cable is inside area:

  • DEWA-approved contractor required

  • Timeline: 2–3 months

  • Separate charges apply

Same applies for water lines.


Old Dubai Area Issue

Areas like:

  • Deira

  • Hor Al Anz

  • Naif

  • Muteena

Often show outdated DEWA data.

Solution:

  • Trial pit verification

  • Inspector confirmation

  • Resubmission


Common Delay Reasons

  • Outstanding payment not cleared

  • Cable passing through plot

  • Water line passing through plot

  • Meter or DB inside demolition area

  • Incorrect drawings

  • Wrong coordinates


Authority Responsibility

  • Dewa Demolition permit → demolition contractor only

  • Meter shifting → DEWA-approved contractor only


Full Demolition Process Flow

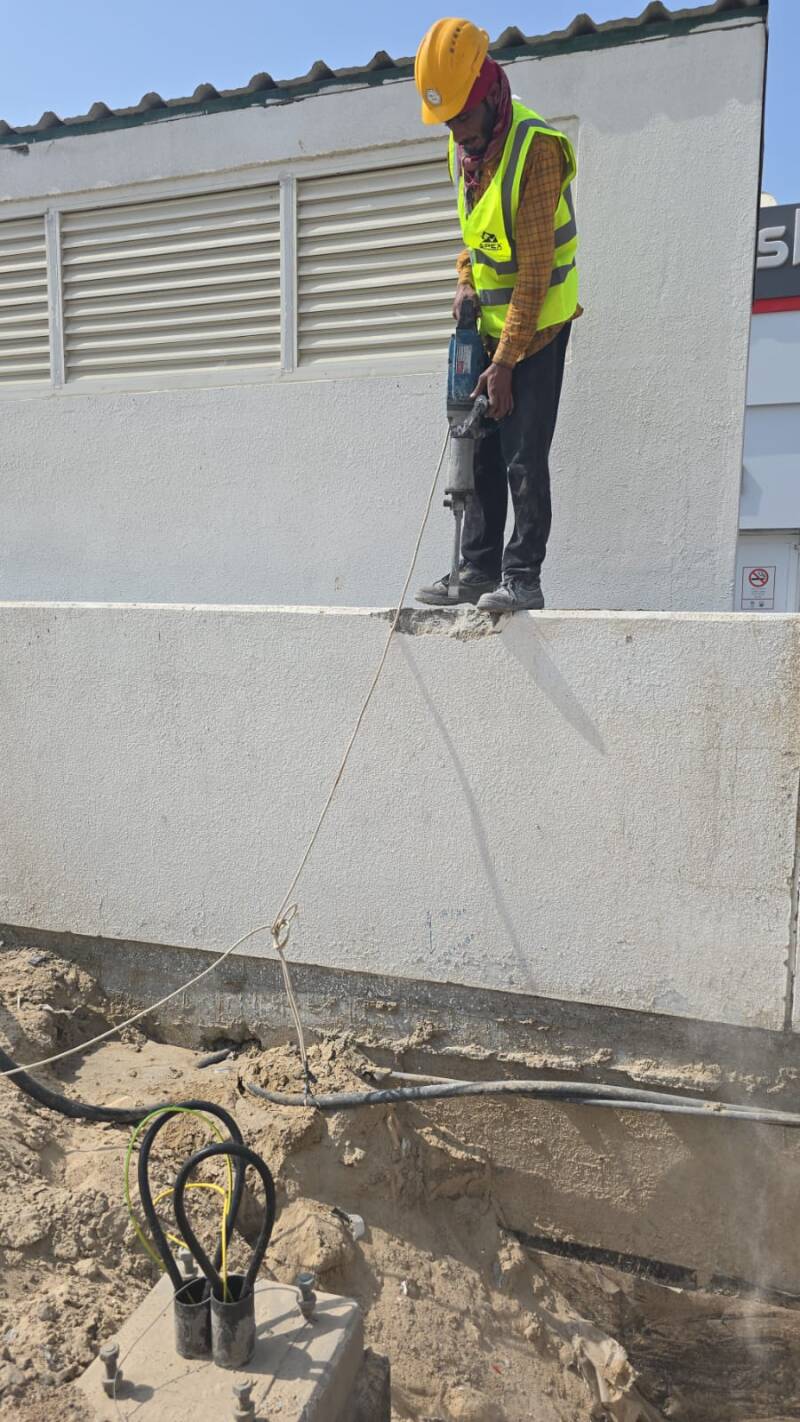

  1. Planning

  2. DEWA disconnection

  3. NOCs approval

  4. Permit submission - Read our previous blog – Building Card in Dubai Municipality Portal (Demolition Guide)

  5. Demolition execution Read our previous blog – Dubai Municipality Circular 2026 for Demolition Contractors Safety Rules

  6. Completion certificate


Related Guides


Final Conclusion

DEWA disconnection and NOC is a mandatory approval step for demolition in Dubai.

Proper handling ensures:

  • faster approvals

  • fewer rejections

  • safe demolition process
