If you own or manage a property in Dubai Investment Park and you're planning demolition — whether it's a full structural demolition or just stripping out a warehouse interior — DIP has its own layer of rules that sit on top of Dubai Municipality requirements. Many contractors and property owners find this out the hard way, mid-project.
This guide covers everything you need to know: DM permits, DIP NOC, the AED 10,000 security deposit, work conditions, undertaking letters, and what happens when your job is interior fit-out only.
What Makes DIP Different from Other Dubai Areas?
Dubai Investment Park is a master-planned mixed-use development managed by Dubai Investments Park Development Co. LLC. Unlike most areas where Dubai Municipality (DM) is the sole authority, DIP operates as a semi-autonomous zone with its own regulatory layer.
This means that even after you obtain your DM permit, you are not cleared to start work. You must separately obtain a DIP NOC before any demolition or construction activity begins on site.
Two Types of Demolition in DIP — and Which Permits Apply
1. Full Structural / External Demolition
For any work that involves structural elements — foundations, load-bearing walls, external envelope, or anything that changes the built footprint — you need both of the following:
- Dubai Municipality Demolition Permit (DM)
- DIP NOC (Dubai Investment Park NOC)
Neither replaces the other. The DM permit does not authorize you to start at DIP, and DIP will not issue its NOC without your DM permit in hand.
2. Interior Fit-Out Demolition Only
This is where many contractors assume they need nothing — and they're half right.
If your scope is limited to interior elements only — removing gypsum partitions, block walls, wall cladding, flooring, false ceilings, and similar fit-out components — with no structural modifications, then:
- DM Permit: Not required
- DIP NOC: Still mandatory

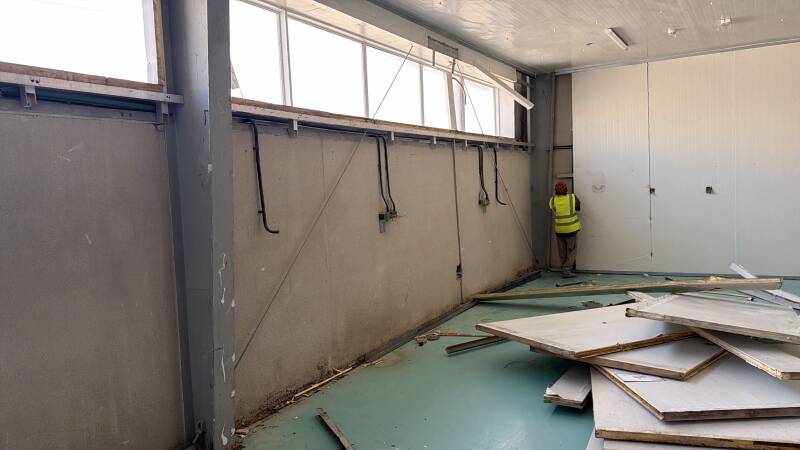

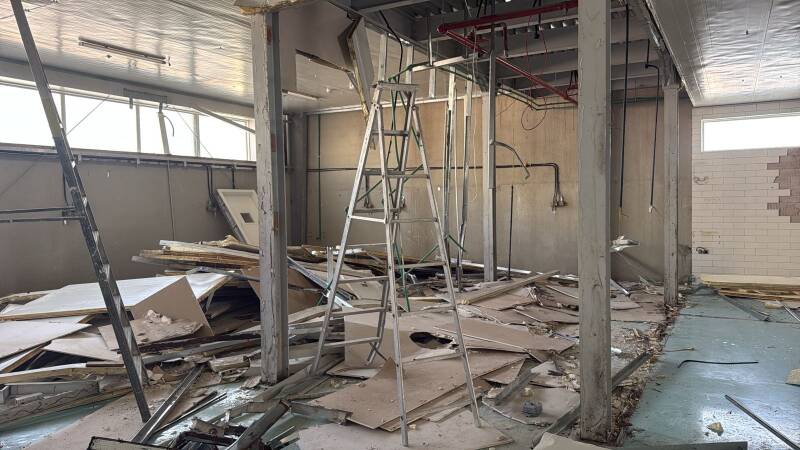

We recently completed an interior demolition job at a warehouse in DIP under exactly these conditions. Our team removed partition walls, wall cladding, flooring, and ceiling finishes — all fit-out elements with no structural changes. The client confirmed the work was done neatly and efficiently with proper site management and no delays. No DM permit was needed, but the DIP NOC was obtained before a single tool went on site.
"Interior demolition work at our warehouse in DIP was done neatly and efficiently. No delays and proper site management." — Afru Puthenparambil, Google Review
The DIP NOC — Full Requirements
Documents Required for DIP NOC Submission
Regardless of whether your job requires a DM permit or not, the DIP NOC submission must include:
- Dubai Municipality Demolition Permit (for structural works only — not required for interior fit-out)
- Work Schedule
- Method Statement
- Demolition Drawing
- signed undertaking letter
- Trade License Copy (of the demolition contractor)
- Deposit Slip for AED 10,000 security deposit
The AED 10,000 Security Deposit
This is a refundable deposit paid to Dubai Investments Park Development Co. LLC. It is not a fee — it is a security deposit that guarantees the contractor will comply with all DIP site regulations.
How to pay: Bank transfer to DIP's account or direct deposit. DIP will provide the account details upon request.
When you get it back: The deposit is refunded after project completion, subject to a site inspection by DIP authority confirming no damage to DIP infrastructure. A receipt of the deposit slip must be submitted as part of the NOC application, and the refund process typically takes approximately 4 weeks after completion.
What you need to get the deposit back:
- Completion Certificate from Dubai Municipality
- Dip issued Receipt of your deposit.
- Owner No Objection Letter (if the applicant is the owner), or Tenant Letter (if the applicant is a tenant)
The Undertaking Letter
Initially DIP will verify the scope of works and Drawings DIP will send you an undertaking letter outlining their site regulations. You must:
- Sign the letter
- Stamp it with the company stamp
- Return it along with the full document package
Only after this step is the NOC formally issued and work can begin.
DIP NOC Conditions — What You're Agreeing To
When you sign the undertaking letter, you are accepting the following obligations. These are non-negotiable:
Site Operations
- Work hours are strictly 7:00 AM to 5:00 PM. No work is permitted after 5 PM without a separate night-shift NOC from both DM and DIP.
- Summer work hour restrictions as specified by DM must be adhered to.
- Stringent safety standards must be maintained at all times.
- The contractor must barricade all working areas and is fully responsible for building safety.
Materials and Waste
- No construction materials or sand may be stored outside plot boundaries.
- Sand cannot be moved outside DIP without a prior NOC from both DM and DIP.
- Backfilling materials or subkha cannot be brought in from outside DIP without NOC from both authorities.
- All loading and unloading must occur within plot boundaries.
- A garbage trolley must be provided for daily use during works.
- The contractor must clean adjacent roads and site entrances and exits daily.
- Debris must be regularly shifted to the DM yard, and the contractor must provide access slips to the DM tip yard.
- No materials of any kind should remain on DIP land after completion of works.
Traffic and Access
- Parking of trailers on roads or roadsides is strictly prohibited.
- Cranes are not permitted to use DIP roads during steel erection.
- Both light and heavy vehicle access routes must be followed. Subcontractors and suppliers must use designated routes.
- Interlocking must be installed at construction entrances and exits before works begin.
Infrastructure Protection
- Fire hydrants must remain accessible and unobstructed at all times.
- The contractor is liable for any damage to DIP infrastructure — including fire hydrants, road signage, asphalt, and landscaping. Damage to services like irrigation pipes will be rectified at the contractor's expense.
- The Final Inspection Chamber (FIC) must be constructed per DIP's as-built drawings and must not be connected without DIP approval. Penalties apply for violations.
Compliance and Oversight
- The contractor is responsible for informing all staff of these regulations and distributing copies of the NOC.
- The contractor is responsible for violations committed by subcontractors.
- DIP has the right to stop work at its discretion in any case of contractor violations.
- No illegal activities — including housing laborers on-site — are permitted.
- For any site emergencies, contact DIP Security: 050 458 7995.
Step-by-Step Process for Demolition in DIP
Step 1 — Determine Your Scope Confirm whether your demolition is structural/external or interior fit-out only. This determines whether you need a DM permit.
Step 2 — Obtain DM Permit (if required) For structural demolition, apply through Dubai Municipality's portal with your demolition drawings, method statement, and engineer approvals.
Step 3 — Share the documents by email- trade license and contact details- documents and get the undertaking letter
Step 3 — Pay the AED 10,000 Deposit Transfer to or deposit into DIP's account. Collect your deposit slip — you will need it for the NOC application and for the deposit refund.
Step 4 — Prepare DIP NOC Documents Compile: DM permit (if applicable), work schedule, method statement, demolition drawing, copy, and deposit slip.
Step 5 — Submit NOC Application to DIP Submit the document package to DIP's development management Email.
Step 7 — Receive DIP NOC and Begin Work Once the NOC is issued, works can commence — strictly within the approved hours and conditions.
Step 8 — Complete Works and Arrange DIP Site Inspection Notify DIP upon completion. A site inspection will be carried out by DIP authority to verify the site is clean and no infrastructure has been damaged.
Step 9 — Collect Deposit Refund Submit your DM Completion Certificate, deposit slip receipt, and owner/tenant NOC letter to claim the AED 10,000 refund. Allow approximately 4 weeks for processing.
Key Differences: DIP Industrial vs. Residential Plots
DIP is a mixed-use zone with industrial, commercial, and residential sub-communities. While the NOC process applies across the board, a few practical differences exist:
Industrial Plots (warehouses, factories, logistics)
- Higher likelihood of interior fit-out-only demolition, which skips the DM permit requirement.
- Debris volumes tend to be larger — confirm DM tip yard access slips are arranged before works start.
- Crane and heavy vehicle movement must follow DIP's designated routes strictly.
Residential Plots (villas, townhouses)
- Full structural demolition is more common, so DM permit is almost always required alongside DIP NOC.
- Party wall and neighbor considerations may apply, similar to other Dubai residential areas.
- Owner/tenant letter requirements for deposit refund are especially relevant given lease structures.
Common Mistakes Contractors Make in DIP
Starting work after DM approval only. The DM permit is not enough. DIP will stop your work on site if you haven't obtained the DIP NOC.
Storing materials outside the plot. DIP patrols its roads and common areas. Materials found outside boundaries result in penalties.
Not planning for the 4-week refund timeline. Budget your project cash flow accordingly — the AED 10,000 is tied up until post-completion inspection and documentation are complete.
Working with a Licensed Demolition Contractor in DIP
Given the dual-authority requirements in DIP, working with a contractor who has direct experience in the zone makes a significant practical difference. Your contractor should:
- Know whether your scope triggers a DM permit or not
- Have the standard DIP NOC document pack ready to compile quickly
- Understand DIP's site conditions and deposit process
- Be able to arrange DM tip yard access slips for debris removal
- Have a trade license that is valid and acceptable to DIP
Al Zelzal Demolition Works LLC is a licensed demolition contractor with completed projects in DIP, covering both full structural demolition and interior fit-out demolition. We handle the NOC process, deposit, method statement, and site compliance so property owners and developers don't have to navigate the dual-authority process alone.
| Requirement | Full Structural Demolition | Interior Fit-Out Demolition |
|---|---|---|
| DM Demolition Permit | Required | Not required |
| DIP NOC | Required | Required |
| AED 10,000 Deposit | Required | Required |
| Method Statement | Required | Required |
| Demolition Drawing | Required | Required |
| Work Schedule | Required | Required |
| Trade License Copy | Required | Required |
| Undertaking Letter (signed & stamped) | Required | Required |
| DIP Site Inspection (on completion) | Required | Required |
| DM Completion Certificate (for deposit refund) | Required | Required |
| Owner/Tenant NOC Letter (for deposit refund) | Required | Required |
| Estimated Deposit Refund Timeline | ~4 weeks | ~4 weeks |
Al Zelzal Demolition Works LLC is a licensed demolition contractor based in Dubai, with experience across DIP industrial and residential projects. Contact us for a site visit and quote.
